Read Time: ⏱️ 10 minutes | By: Luca
How Much Does 7 BBL Brewery Equipment Cost?

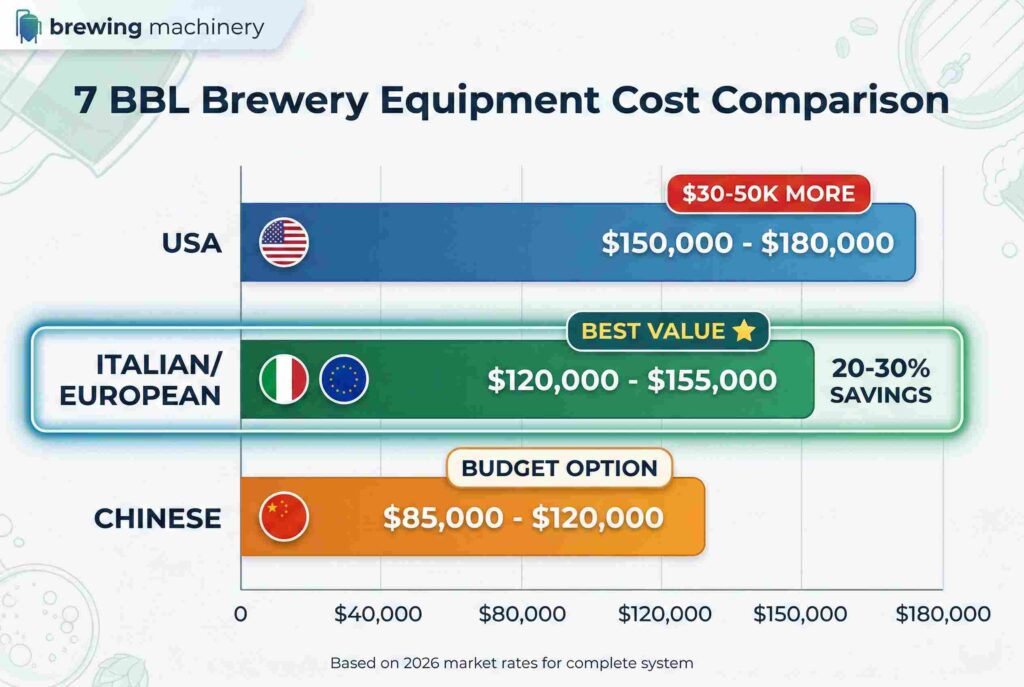

A new 7 BBL brewhouse commonly starts near $85,000 to $100,000, while a broader installed brewery package can reach $150,000 to $300,000 or more. The final budget depends on the heating method, vessel count, automation, fermenters, brite tanks, glycol cooling, freight, installation, and building work.
One US beer barrel equals 31 gallons. A 7 BBL batch therefore represents about 217 gallons, 821 liters, or roughly 1,736 US pints before normal process and packaging losses.
The advertised brewhouse price is only one part of the investment. A working brewery also needs cellar tanks, temperature control, cleaning equipment, utilities, fittings, grain handling, packaging, and enough working capital to operate before sales become steady.
7 BBL Brewery Cost at a Glance
| Cost Area | Typical Planning Range | What It May Include |
|---|---|---|
| 7 BBL brewhouse | $85,000–$100,000+ | Hot-side vessels, pumps, controls, platform, and heat exchanger |
| Cellar package | $35,000–$100,000+ | Fermenters, brite tank, glycol chiller, controls, and connections |
| Supporting equipment | $15,000–$60,000+ | Mill, hoses, fittings, CIP equipment, keg washer, and lab tools |
| Freight and installation | 15%–30% of equipment cost | Shipping, rigging, plumbing, electrical work, and commissioning |
| Building preparation | Varies by site | Drainage, flooring, ventilation, utilities, permits, and structural work |
These figures are planning ranges, not fixed supplier quotes. Currency, location, steel prices, customization, taxes, and local construction rates can change the installed cost substantially.
Who Is a 7 BBL System Best For?
A 7 BBL brewery is usually a good fit for a brewpub, taproom, restaurant brewery, or small craft producer serving a local market. It offers more output than a pilot or nano system without requiring the space and capital of a large production brewhouse.
The size works best when most beer is sold directly at a healthy margin. A business focused on wide wholesale distribution may outgrow it sooner because producing the same annual volume requires more brew days, labor, cleaning cycles, and transfers.
Section 1: Introduction to Capital Asset Allocation in Modern Beverage Production
Planning the finances of a commercial craft beer startup means making key choices about your physical plant.
New production managers often debate the trade-off between buying used machinery and investing in custom-built factory systems.
This capital choice usually centers on comparing used vs new brewery equipment setups to find which one gets you to profitable operation faster.
Every cellar line, hot-side vessel, and packaging conveyor on your floor affects your debt-to-equity ratio and your starting cash.
If a startup spends its whole credit line on high-end custom brewhouse designs, it may run out of working capital before its first batch is packaged.
On the other hand, cheap, poorly maintained used lines can quickly cause unexpected downtime and processing delays.
To learn the business basics of asset depreciation and capital management over multi-year schedules, see Wikipedia: Return on Investment.
Whether you run a local taproom or a large packaging floor, your hardware choices set your margins.
Using a clear financial framework protects your business from sudden maintenance spikes and costly bottlenecks.
Treat Published Prices as Comparison Points
The number shown beside a 7 BBL brewhouse is rarely the amount you will spend before your first brew day.
Treat published starting prices as comparison points, not complete installed costs.
Confirm whether the quote includes pumps, controls, platforms, piping, a heat exchanger, commissioning, freight, taxes, installation labor, and operator training.
Optional automation and custom vessel layouts can raise the final amount a lot.
The useful question is not just “what does the system cost?” but “what is included, what is optional, and what must be bought elsewhere?”
Section 2: Evaluating Cellar Analytics and Quality Control Testing Tooling
To keep your beer quality steady across thousands of barrels, you need a strong chilling routine in your cellar.
Your testing spaces must be fully equipped to track basic parameters like dissolved oxygen, microbe counts, and gravity drops.
A dedicated, high-performance brewery lab equipment setup lets managers catch process problems long before bbl brewery equipment beer reaches distribution.
Before any wort moves to the fermentation tanks, the lab team must run detailed quality checks.
The samples must be examined with precise lab instruments to confirm healthy yeast and clean fermentation.
A poorly equipped lab can lead to spoilage, off-flavors, and major recalls that ruin brand trust.
To study the biology and chemistry used to keep quality standards in modern food plants, see Wikipedia: Quality Control.
A dedicated testing layout keeps your beer free from stress-induced yeast esters, sulfur, and temperature spikes.
![3. 7 BBL Brewery Equipment: Complete Cost Breakdown & Supplier Guide [2026] 1 7 BBL brewhouse systems bbl brewery equipment](https://brewingmachinery.com/wp-content/uploads/2026/03/7-BBL-brewhouse-system-1024x572.jpg)
Section 3: The Deep Evolution of Liquid Processing Technologies
The machines in a modern beverage plant are the result of centuries of metallurgical innovation and industrial refinement.
When a team reviews the history of brewing and the evolution of brewing technology, they see how ancient wooden vessels became modern automated stainless steel systems.
A multi-stage cellaring system lets managers fully control the metabolic heat before yeast pitching begins.
This stable environment gives the team control over the growth parameters for either crisp clean characters or deep, rounded fruity complexity.
Without this control, the heat from active yeast can push the tank core temperature far past its ideal point.
A high core temperature pulls harsh fusel alcohols from the sugars, leaving a solvent-like burn in the finished beer.
To explore the early history of food preservation, ancient fermentation, and old farming traditions, see Wikipedia: History of Beer.
With a clean thermal setup, every batch reaches its best flavor, saving thousands of dollars in lost product each year.
During the brew day, the mash tun plays an important role in keeping the mash stable and controlled.
Good heating elements help maintain the right temperature during the mashing process, improving sugar extraction and consistency.
Sight glasses are also useful because they allow the brewer to monitor liquid levels more easily without opening the vessel.
Section 4: Mechanical Integrity and Sanitary Engineering Verification Protocols
A modern, high-output cellar relies on a precise chain of mechanical and electrical parts to protect its core tanks.
Before the wort ever meets the cold yeast, it must pass through a long sequence of mechanical steps.
This cold-side setup usually needs a professional brewery weld inspection to make sure every joint is smooth and sanitary.
The inspector checks the inside of the lines for tiny cracks, pockets of slag, or rough weld lines.
Any small defect in a product line can hold organic residue and shield wild bacteria from standard clean-in-place chemical loops.
To learn the industrial protocols used to check metal joints in food-grade piping, see Wikipedia: Welding.
Finally, the control board reads signals from submerged resistance temperature detectors, which read small thermal changes instantly.
Give Supporting Equipment Its Own Budget
Small accessories have a habit of becoming a surprisingly large invoice.
Supporting equipment should have its own budget category.
It can include hoses, sanitary fittings, pumps, cleaning equipment, a plate heat exchanger, steam-management parts, pilot equipment, and extra hot or cold liquor storage.
A basic allowance may be enough for a simple taproom, while a complete install needs a much larger reserve.
A brewery needs far more than the visible stainless steel tanks, so itemize hoses, clamps, fittings, pumps, and connection hardware before approving the order.
![3. 7 BBL Brewery Equipment: Complete Cost Breakdown & Supplier Guide [2026] 2 Brewery Equipment Cost comparison chart (USA-Italian-Chinese)](https://brewingmachinery.com/wp-content/uploads/2026/03/Brewery-Equipment-Cost-comparison-chart-USA-Italian-Chinese-1024x687.jpg)
Section 5: Regulatory Compliance, Audits, and Operational Accountability
Meeting local safety rules and regional compliance targets means keeping detailed paperwork for every part of your facility.
To pass surprise government walkthroughs, follow a thorough brewery inspection checklist every single day.
Your checklist must verify correct backflow preventers, safe chemical storage, and automatic temperature cutoff valves.
Failing these safety and sanitation standards can bring immediate fines, forced closures, or long-term legal trouble.
A professional floor also needs enough spare capacity to crash several vessels at once while keeping steady cold-storage conditions.
Undersizing this utility creates severe scheduling bottlenecks, forcing your crew to wait hours for the cold spaces to settle.
To study how national agencies monitor manufacturing to protect workers and consumers, see Wikipedia: Food and Drug Administration.
Include Ergonomics in the Cost Analysis
A brewery team repeats the same physical tasks hundreds of times a year.
Judge ergonomics as part of the equipment cost analysis.
Valve height, platform access, control-panel position, grain-out doors, hose routing, and safe movement around the vessels all affect daily labor.
Poor equipment placement raises lifting, bending, cleaning time, and the risk of injuries.
A valve that is hard to reach or a grain-out door set too low looks minor at install, but it becomes a daily source of wasted time and strain.
Section 6: Global Procurement Strategies and Supply Chain Logistics
Running a high-capacity plant brings real environmental duties and strict regional energy rules.
Cooling hot wort down to fermentation temperature makes a big stream of hot water inside the plate exchanger.
When outfitting a new floor, founders often import brewery equipment from premium international makers to build their tank farms.
Managing this global path means understanding marine freight schedules, tariff codes, and harbor clearance.
Advanced facilities send this pre-heated water into storage vessels and reuse it as hot liquor for the next mash or cleaning loop.
Failing to plan for long shipping times or port delays can stall construction and spike warehouse overhead.
To study how logistics firms manage freight and clear cross-border shipments, see Wikipedia: Customs Brokers.
Budget External Heating and Cooling Separately
A quoted kettle is not necessarily a complete heating system.
External heating and cooling parts may not be in the advertised brewhouse price.
Budget separately for the boiler or heating unit, plate heat exchanger, pumps, piping, ventilation, water connections, and install labor.
Size the heat exchanger to the incoming water temperature and the wort-cooling time you need.
Boilers, burners, heat exchangers, connections, and professional install can add thousands of dollars, so confirm them before comparing suppliers.
Match the Steam Generator to the Brewhouse
Buying an oversized brewhouse with an undersized steam generator creates an expensive bottleneck.
Match the steam-generator capacity to the brewhouse design and your target schedule.
A boiler that is too small raises heating times and stops you from hitting your planned daily batches.
Ask the supplier for steam-demand math covering the mash tun, kettle, hot liquor tank, piping losses, and any heating that happens at the same time.
The vessels may be the right volume, but you will still wait all day for temperature if the utility cannot keep up.
Section 7: Sizing the Initial Cellar and Selecting Tank Volume Configurations
What Is Included in a Complete 7 BBL Brewery System?

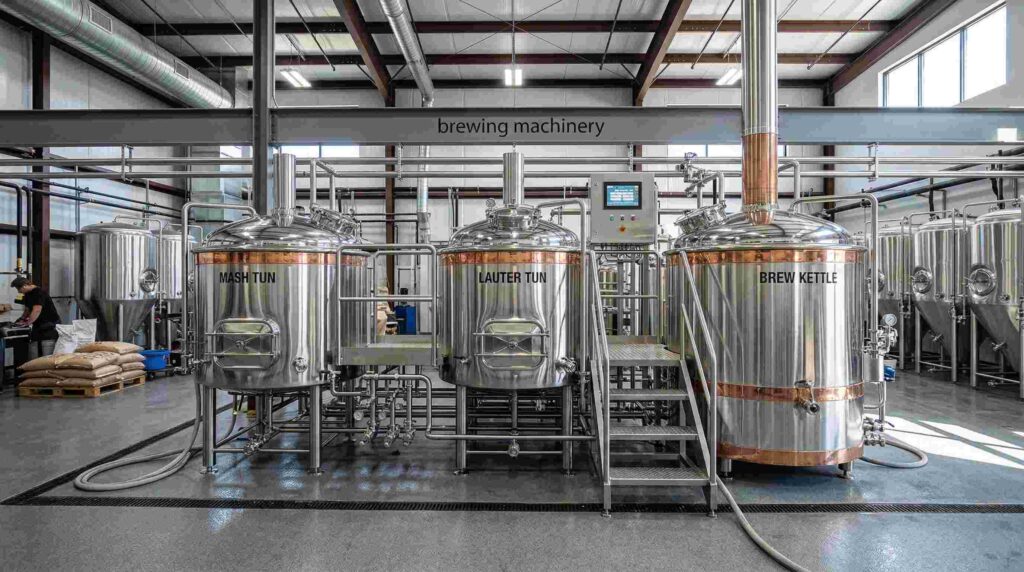

A complete 7 BBL brewery is more than a mash tun and kettle. The exact package changes by supplier, but the main equipment should support every stage from milling and hot-side production to fermentation, conditioning, cleaning, and packaging.
Hot-Side Brewhouse Equipment
- mash and lauter vessel with false bottom and sparge assembly;
- brew kettle and whirlpool vessel, either combined or separate;
- hot liquor tank sized for the intended brewing schedule;
- sanitary wort and water pumps;
- plate heat exchanger for cooling wort before fermentation;
- working platform, stairs, rails, valves, piping, and controls;
- electric elements, direct-fire burners, or steam jackets;
- temperature, flow, and level instruments required by the design.
A two-vessel brewhouse combines several functions and uses less floor space. A three- or four-vessel configuration separates more operations, allowing faster turns and overlapping production, but it costs more and needs additional room and utilities.
Cold-Side Cellar Equipment
- four to six jacketed fermenters for a practical starting cellar;
- one or two brite tanks for conditioning and packaging;
- a correctly sized glycol chiller, reservoir, pumps, and insulated piping;
- individual tank temperature controls, probes, and solenoid valves;
- COâ‚‚ regulation and safe gas-distribution equipment;
- sanitary hoses, clamps, gaskets, valves, and transfer fittings;
- a mobile or fixed clean-in-place system.
The cellar often determines the brewery’s true output. A brewhouse can make another batch in a day, but beer may occupy a fermenter for two to four weeks. Too few fermenters leave the hot side idle even when customer demand is strong.
Packaging and Service Equipment
A taproom may begin with kegs, a keg washer, cold storage, and a balanced draft system. A brewery selling cans or bottles must also budget for filling equipment, label application, date coding, pack-out tables, compressed air, quality checks, and additional cold storage.
Ask whether the package includes commissioning, operator training, spare parts, manuals, electrical drawings, pressure certificates, and after-sales support. These items may not appear in the equipment photograph, but they have real operational value.
7 BBL Production Capacity and Packaged Yield
A nominal 7 BBL batch begins at approximately 217 US gallons or 821 liters. The volume reaching customers is lower because wort and beer are lost to grain absorption, hops, trub, yeast, transfers, samples, and packaging.
A realistic plan should use packaged yield rather than the vessel nameplate. Depending on recipe and process control, a brewery may package roughly 75% to 85% of the nominal brew length. Heavily hopped beer normally creates greater losses than a low-hop lager or ale.
| Measure | Nominal 7 BBL Batch | Example at 80% Yield |
|---|---|---|
| US gallons | 217 gallons | About 174 gallons |
| Liters | About 821 liters | About 657 liters |
| US pints | About 1,736 pints | About 1,389 pints |
| Half-barrel kegs | 14 theoretical kegs | About 11 full kegs |
Annual output depends on the number of batches, fermenter availability, beer style, maturation time, cleaning, and downtime. At three batches per week for 50 weeks, nominal production is 1,050 BBL. At four batches per week, it is 1,400 BBL before losses.
Do not build the sales forecast from the maximum theoretical number. Use a conservative packaged yield, allow time for maintenance and slow fermentations, and check whether the cellar and packaging line can handle the same weekly volume as the brewhouse.
Designing a reliable fluid layout means mounting industrial-grade parts on a rigid, low-resistance overhead support grid.
For mid-sized regional taprooms, a standard 7 barrel brewing system gives a good balance of batch flexibility and weekly volume.
This size lets your team run small specialty batches while keeping the core flagship recipes flowing.
Avoid low-grade PVC or thin uninsulated flexible lines on glycol loops, since they crack and sweat constantly.
Balance valves on each tank branch let operators watch and trim the system’s hydraulic pressure in real time.
Install pressure-relief bypass loops right after the main pump station to handle closed-valve deadhead situations quickly.
To study the engineering math and fluid dynamics used to scale vessel sizes, see Wikipedia: Chemical Engineering.
Consider a Two-Vessel Brewhouse
More vessels do not automatically make a system better for every brewery.
A two-vessel brewhouse can cut both the upfront investment and the floor space needed.
Combining several steps in two vessels leaves more room for fermenters and makes operation and maintenance easier.
Fewer vessels can also reduce install work, energy use, and long-term maintenance.
A compact two-vessel layout is sensible when floor space and startup capital are limited, but you must check batch timing and how many brews you can finish each day.
Rakes, Plows, and an Accessible Manway
Removing hundreds of pounds of wet grain by hand after every brew gets tiring fast.
Rakes, plows, and a side manway can cut the labor of removing spent grain from a 7 BBL mash tun.
These features add to the price but can shorten grain-out time, improve mash-bed management, and reduce manual handling.
Weigh their value against your labor costs over the equipment’s expected life.
A powered rake and plow costs more upfront, but it makes the brew day faster, safer, and less tiring for a small team.
Section 8: Financial Forecasting and Enterprise Capital Budgeting Requirements
Space, Utilities, and Site Requirements
The tanks must fit through the building before they can produce beer. Confirm door width, ceiling height, turning space, loading access, vessel diameter, platform height, and the path used by rigging equipment before approving fabrication.
How Much Space Does a 7 BBL Brewery Need?
A compact installation may fit the core equipment into a relatively small production area, but a practical brewery needs room for grain, fermentation, cold storage, cleaning, packaging, chemicals, finished goods, and safe staff movement. Many projects plan approximately 1,000 to 1,500 square feet for the production zones, then add customer, office, kitchen, and warehouse space as required.
There is no universal footprint because vessel layout and business model change the answer. Request a scaled equipment drawing and place it over the real building plan. Include door swings, columns, floor drains, hose routes, electrical panels, boiler clearance, and future tank positions.
Water, Drainage, and Wastewater
Brewing uses water for the recipe, vessel cleaning, floor cleaning, cooling, and packaging. Test the incoming water and confirm pressure, flow, hardness, alkalinity, chlorine, and seasonal temperature before final equipment sizing.
Floors should be durable, chemical-resistant, properly sloped, and easy to clean. Drains must accept peak flows from tanks and cleaning without backing up. Local authorities may also require wastewater sampling, pH control, solids removal, or a discharge agreement.
Electrical, Steam, Gas, and Ventilation
Electric brewhouses require sufficient service capacity for heating elements, pumps, chillers, controls, cold rooms, and packaging equipment. Steam systems add a boiler, water treatment, steam and condensate piping, inspections, ventilation, and trained operation. Direct-fire systems require approved fuel connections, combustion air, and safe exhaust design.
Ask the manufacturer for a complete utility schedule showing voltage, phase, amperage, heating load, steam demand, water flow, drain flow, glycol load, compressed-air demand, and connection sizes. Give this schedule to qualified local contractors before purchasing the equipment.
Structural Loads and Ceiling Clearance
A tank that appears light when empty becomes a major structural load when filled. The site engineer should consider the wet weight of vessels, platforms, boilers, cold rooms, stored grain, kegs, and palletized products.
Measure the total installed height, not only the tank shell. Legs, top fittings, valves, motors, vent stacks, manways, lifting clearance, and service access can determine whether the equipment works safely in the building.
Electric, Steam, or Direct-Fire Heating?
| Heating Method | Main Advantage | Main Limitation | Best Fit |
|---|---|---|---|
| Electric | Simple control and no separate steam boiler | May require a large electrical-service upgrade | Smaller sites with suitable electrical capacity |
| Steam | Even heating and strong multi-batch performance | Higher installation cost and boiler requirements | Breweries planning frequent production |
| Direct fire | Familiar technology and potentially lower entry cost | Needs combustion air, exhaust, and careful heat control | Buildings with approved gas infrastructure |
The cheapest vessel quote is not always the cheapest installed system. Compare the equipment price together with electrical upgrades, boiler work, fuel supply, ventilation, inspections, energy use, maintenance, and the time required to heat each batch.
The final flavor of your beer has a lasting effect on how many customers come back.
When building your early financial model, working out how much does it cost to start a brewery means tracking several major cost groups.
These include real estate leasing, water drainage upgrades, specialized plumbing, and your main machinery purchases.
As sugar use slows, the team raises the target temperature to run a proper diacetyl rest.
This warming step helps the yeast reabsorb vicinal diketones, preventing a slick or buttery aroma in the beer.
Starting with a well-controlled cellar program lets your team move through these biological phases for clean maturation.
To review how small businesses manage loans, building costs, and daily cash flow, see Wikipedia: Startup Company.
Budget Beyond the Brewhouse Itself
A low brewhouse price can make a quote look attractive, but the brewery cannot run on the brewhouse alone.
A realistic 7 BBL budget must include more than the brewhouse.
A small commercial package usually needs four to six fermenters, one or two brite tanks, a glycol chiller, a CIP cart, and a control panel.
Depending on automation, tank count, and configuration, the core equipment package can fall in a broad price range.
Fermenters, brite tanks, cooling gear, cleaning tools, and controls can be a large part of the final investment, so compare complete equipment lists, not one headline price.
Weigh Electric vs Steam Heating
Choosing between electric and steam is not just comparing two brewhouse quotes.
The heating method is one of the main factors in a 7 BBL brewhouse price.
Electric systems can cost less and install more simply in some buildings.
Steam systems usually need a separate boiler, steam piping, ventilation, inspections, and extra safety parts, but they heat evenly and support faster production.
The building may need electrical upgrades for one option or a boiler room and steam infrastructure for the other, so compare the complete installed utility cost.
![3. 7 BBL Brewery Equipment: Complete Cost Breakdown & Supplier Guide [2026] 3 Infographic showing Henrys Law beer carbonation physics temperature vs pressure comparison](https://brewingmachinery.com/wp-content/uploads/2026/02/Chart-Visualization-1024x559.jpg)
Section 9: Structured Project Milestones for Facility Development
Every classic beer style grew from the specific processing conditions of its home region.
Laying out the exact steps to start a brewery keeps your project moving from early business-plan drafts to opening day.
These steps include securing federal wastewater permits, laying thick antimicrobial floor coatings, and tuning your automated glycol chillers.
A true Belgian Saison, for example, needs a warm environment allowed to rise past 80 degrees Fahrenheit, which brings out spicy phenolics.
With a multi-zone control panel, your team can move from a warm ale on tank one to a cold lager on tank two.
This flexibility lets one plant make a wide range of world-class beverages without quality drops.
To review the project management tools and schedules used to guide complex construction, see Wikipedia: Project Management.
Give Grain Handling Its Own Place in the Plan
The brewing process starts before grain enters the mash tun.
Include grain handling in the full 7 BBL equipment budget.
You may need a suitable malt mill, grain hopper, auger, dust-control setup, and explosion-rated motor before malt reaches the mash tun.
Size the milling system to prepare the full grain bill without slowing the brewing schedule.
A mill that is too small slows every production day, while poorly managed grain dust creates cleaning and safety problems.
Section 10: Selecting the Optimal Business Model for Long-Term Profitability
Choosing how to source your main refrigeration assets means balancing your startup capital against long-term maintenance.
Entrepreneurs must weigh the pros and cons of a microbrewery or brewpub model to match their local market.
A microbrewery focuses on high-volume packaging and wholesale distribution to earn through regional retail shelves.
A brewpub relies on high-margin on-site taproom sales, mixing house-brewed drinks with full kitchen food service.
New custom systems include full manufacturer warranties, direct technical support, and modern wiring that meets local codes.
A common strategy is buying a new core chiller skid while sourcing used secondary piping and storage tanks.
Whatever path you choose, checking the electrical ratings and reliability of every compressor prevents costly product losses later.
Section 11: Capital Expenditure Comparison Matrix
How to Compare 7 BBL Brewery Equipment Quotes
Two quotes with the same capacity can describe very different systems. Compare them line by line instead of choosing the lowest total shown on the final page.
- Confirm vessel working volume. Ask whether 7 BBL refers to finished wort, kettle working volume, or total vessel capacity.
- Check the steel specification. Confirm material grade, sheet thickness, interior finish, weld treatment, insulation, and jacket design.
- Compare the complete equipment list. Identify every pump, valve, fitting, instrument, platform, heat exchanger, control, and accessory.
- Review the heating package. Confirm whether elements, burners, steam boiler, piping, condensate return, and ventilation are included.
- Verify cellar capacity. Compare fermenter and brite-tank quantity, working volume, pressure rating, jackets, and controls.
- Request utility requirements. Obtain exact electrical, water, steam, gas, glycol, drainage, and compressed-air loads.
- Clarify delivery terms. Check freight, insurance, duties, taxes, unloading, rigging, installation, and commissioning.
- Evaluate support. Review warranty length, exclusions, spare-parts availability, response time, remote assistance, and operator training.
- Request documentation. Obtain drawings, manuals, certificates, wiring diagrams, pressure records, and recommended maintenance schedules.
- Calculate installed cost. Add every expense required to complete the brewery rather than comparing factory prices alone.
New vs Used 7 BBL Brewery Equipment
Used equipment can reduce the purchase price and may be available faster, but it needs careful inspection. Confirm vessel history, pressure rating, jacket condition, weld quality, controls, replacement-part availability, and whether the dimensions match the new building.
A used tank is not a bargain if it needs extensive repairs, lacks documentation, or cannot fit through the door. Include dismantling, transport, refurbishment, new controls, installation, and lost production time in the comparison.
New equipment costs more but can be designed around the site, product mix, utility supply, and planned workflow. It normally provides current documentation, a defined warranty, commissioning support, and easier integration with automation.
Domestic vs Imported Brewery Equipment
Domestic supply may provide faster communication, local service, familiar standards, and easier access to replacement parts. Imported equipment may offer a lower factory price or broader customization, but the buyer must account for freight, customs, duties, inland transport, time zones, and longer replacement-part lead times.
Ask every supplier to quote on the same scope and delivery basis. A domestic installed price cannot be compared fairly with an imported ex-works price until all logistics, taxes, contractors, and commissioning costs are added.
Warning Signs in a Brewery Equipment Quote
- the supplier will not confirm working volume or pressure rating;
- drawings and utility schedules are unavailable before production;
- important components are described only as standard or equivalent;
- the quote omits freight terms, installation boundaries, or exclusions;
- the warranty does not explain labor, shipping, or replacement parts;
- there is no clear process for factory testing and final acceptance;
- the system price is unusually low but the cellar and utilities are missing.
A reliable proposal should make the scope easy to understand. Unclear details create change orders, delays, and unplanned costs after the purchase decision has already been made.
Choosing your asset portfolio means balancing upfront equipment costs against long-term operating efficiency.
The reference below compares the typical costs and operating life of the different equipment options.
┌──► Initial cost: 40% to 60% of new retail
[Used Broker Equipment] ├──► Mechanical life: 3 to 7 years
└──► Warranty: as-is, no manufacturer support
┌──► Initial cost: 85% to 110% of new retail
[Direct European Import] ├──► Mechanical life: 15 to 25 years
└──► Warranty: limited overseas parts warranties
┌──► Initial cost: 100% to 130% of new retail
[Domestic Custom Built] ├──► Mechanical life: 20 to 30 years
└──► Warranty: full comprehensive local support
┌──► Initial cost: 120% to 150% of new retail
[Turnkey Automated Skids] ├──► Mechanical life: 20+ efficient years
└──► Warranty: 24/7 remote monitoring support
Section 12: Metallurgical Integrity and Clean-In-Place Cold Sanitization Loops
The reactions between your steel jackets, cleaning agents, and tanks affect how long your equipment lasts.
Commercial cellar vessels must be made from strong stainless steel, usually AISI 304 or acid-resistant AISI 316L.
These alloys have plenty of chromium and nickel, which form a passive oxide layer that protects the metal.
This layer guards your tanks against cleaning acids, hot sanitizing solutions, and strong interior fluid forces.
To stop wild microbes, the inside steel must be polished very smooth, with a low roughness average.
Rough patches, welds, or scratches can hide residue and shield wild bacteria from normal cleaning.
To keep the high sanitary standards on the floor, maintenance must follow strict sanitizing loops.
![3. 7 BBL Brewery Equipment: Complete Cost Breakdown & Supplier Guide [2026] 4 Equipment layout diagram](https://brewingmachinery.com/wp-content/uploads/2026/03/Equipment-layout-diagram-1024x572.jpg)
Section 13: Facility Safety and Refrigerant Containment Systems
Running an industrial cellar means balancing high pressures and special chemicals with strict local laws.
The high-pressure lines and dense refrigerants in your condenser units cannot leak into the workspace.
To meet safety laws, modern plants must fit a dedicated refrigerant leak-detection system.
This system samples the air near your compressor skids and triggers alarms automatically if levels spike.
Your crew must also wear full protective gear, including electrical safety gear, heavy gloves, and face protection during line servicing.
By making safety and the environment a priority, you protect your staff and avoid legal delays.
Section 14: Final Summary and Operational Growth Blueprint
7 BBL Brewery Equipment FAQ
What does 7 BBL mean?
BBL is the standard US beer-barrel measurement. One BBL equals 31 US gallons, so 7 BBL equals approximately 217 gallons or 821 liters before production losses.
How much does a 7 BBL brewhouse cost?
A new 7 BBL brewhouse may start around $85,000 to $100,000, depending on configuration and automation. A complete installed brewery costs more because it also needs fermenters, cooling, cleaning, utilities, freight, installation, and building preparation.
How much beer can a 7 BBL system produce?
A single nominal batch is 7 BBL, or about 217 gallons. At three batches per week for 50 weeks, theoretical annual output is 1,050 BBL. Actual packaged volume is lower because of process losses, downtime, cellar availability, and product mix.
How many fermenters does a 7 BBL brewery need?
Four to six fermenters provide a practical starting point for many small breweries. The correct number depends on weekly sales, batches per week, fermentation time, beer styles, and whether tanks are used for conditioning.
How many pints are in a 7 BBL batch?
Seven US beer barrels contain approximately 1,736 US pints before losses. At an example packaged yield of 80%, the batch would provide about 1,389 pints before allowing for serving waste.
How many kegs come from a 7 BBL batch?
The nominal volume equals 14 half-barrel kegs. Real output may be closer to 10–12 full half-barrel kegs after fermentation, transfer, and packaging losses.
How much space is required for a 7 BBL brewery?
Many small projects plan roughly 1,000 to 1,500 square feet for production zones, but the final requirement depends on the cellar, cold storage, packaging, grain storage, utilities, customer areas, and future expansion.
Is electric or steam better for a 7 BBL brewhouse?
Electric heating can simplify the installation when the building has enough electrical capacity. Steam offers even heating and strong multi-batch performance but requires a boiler and additional infrastructure. The best option depends on the site and production schedule.
Can a 7 BBL system support a brewpub?
Yes. A 7 BBL system is commonly suited to brewpubs and taprooms because it provides meaningful batch volume while retaining flexibility for rotating recipes and direct on-site sales.
What is usually excluded from the advertised price?
Common exclusions include freight, duties, taxes, unloading, rigging, utility upgrades, installation labor, permits, boiler work, glycol piping, commissioning, training, packaging equipment, and building improvements.
What should be checked before ordering?
Confirm working volume, dimensions, wet weight, heating method, utility loads, pressure ratings, tank quantity, included accessories, delivery terms, documentation, warranty, installation boundaries, and local code requirements.
Final Buying Checklist
- base the brewery size on realistic sales and packaged yield;
- compare complete installed costs rather than advertised starting prices;
- confirm that the cellar can support the planned weekly brew schedule;
- verify the building, utilities, drainage, ventilation, and structural loads;
- request detailed drawings and technical documentation before fabrication;
- include freight, rigging, installation, commissioning, and training;
- reserve working capital for ingredients, payroll, packaging, and slow sales periods;
- leave physical and utility capacity for future fermenters.
The right 7 BBL brewery equipment is the system that matches your building, sales model, staffing, utilities, and realistic production plan. A clear specification and complete installed-cost comparison are more valuable than choosing the lowest headline price.
Choosing your core setup needs a clear view of your sales goals, your space, and your budget.
If you run a taproom where beer moves fast on-site, a compact automated chiller skid is an affordable start.
But if you want to grow automated wholesale lines across many states, a fully integrated multi-compressor system is a must.
Check your building’s floor weight limits, balance your glycol concentrations, and enforce strict validation loops.
Pick the right setup for your volume, treat your thermal control as a key partner, and your team will deliver excellent products.
Contact Us
![3. 7 BBL Brewery Equipment: Complete Cost Breakdown & Supplier Guide [2026] 5 Luca Chiumento](https://brewingmachinery.com/wp-content/uploads/2026/07/Luca.webp)
Author | Operations & Sourcing Lead
Luca is an operations and sourcing specialist with extensive experience in project management and industrial manufacturing. This blog serves as a technical resource for brewery owners, offering clear guidance on equipment design, quality control, and supplier evaluation. In parallel, Luca advises international buyers on sourcing and importing brewing equipment—helping them manage risk, avoid costly mistakes, and achieve consistent production quality.
